Monthly Updates

Construction Project Status

For the period of performance September 1-30, 2022

(updated December 15, 2022)

Project earned value toward the MREFC effort rose $4.9 million this month to a calculated $463.8 million. The cost variance changed -$0.2 million this month to $1.7 million, and the cost performance index held at 1.0. The schedule variance changed by $.4 million to -$6.7 million, which equates to a schedule performance index of 0.99. Twelve project controls change requests (LCRs) were implemented this month, requesting a total of $1,018,176 from contingency. As of the end of the month, the project has allocated 79% of the total contingency to the baseline through the change control process. The remaining contingency of $17.4 million is 66% of (TPCII  -BAC -CV)/(EACII -ACWP ).

(ETC = Estimate to completion, BAC = Budget at completion, BCWP = Budgeted cost of work performed).

Frequent updates can be found on our Blog posts and Digest. A Day in The Life of LSST may also be of interest.

Select Milestones


Updated with post Covid replan dates pending agency approval

The table shows forecast dates, i.e., the Project’s current best estimate. There is, in addition, schedule contingency that is not included in those dates, amounting to about 6 weeks at present. It is likely that the Project will use most or all of that schedule contingency.

The schedule for science data is best estimated relative to the System First Light Milestone. The Operations Team, in consultation with the Rubin Construction Project, currently anticipate the following:

  • The first data preview release (DP1, for details see http://ls.st/rtn-011, which is currently under revision), based on a subset of images supporting the System First Light milestone: 2-3 months after System First Light
  • The LSST Survey start: 4-7 months after System First Light. Some “near-live” alerts are planned around the time of the LSST Survey start, and then alert production is planned to increase smoothly to "live" during the early months of the LSST Survey, covering more regions over time as the static-sky templates are built up.
  • Data Preview 2 (DP2): 9-12 months after System First Light
  • Data Release 1 (DR1): 12-14 months after LSST Survey start

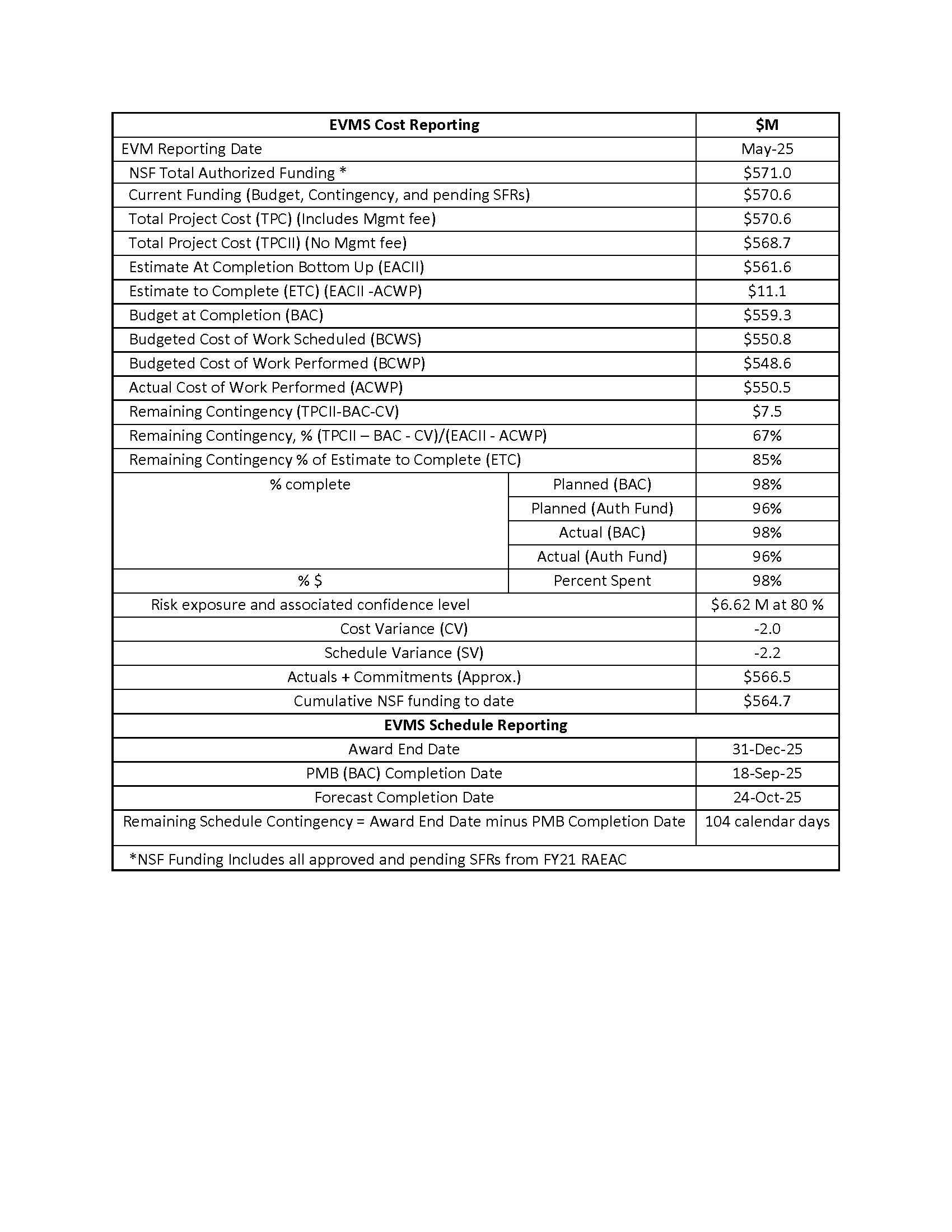

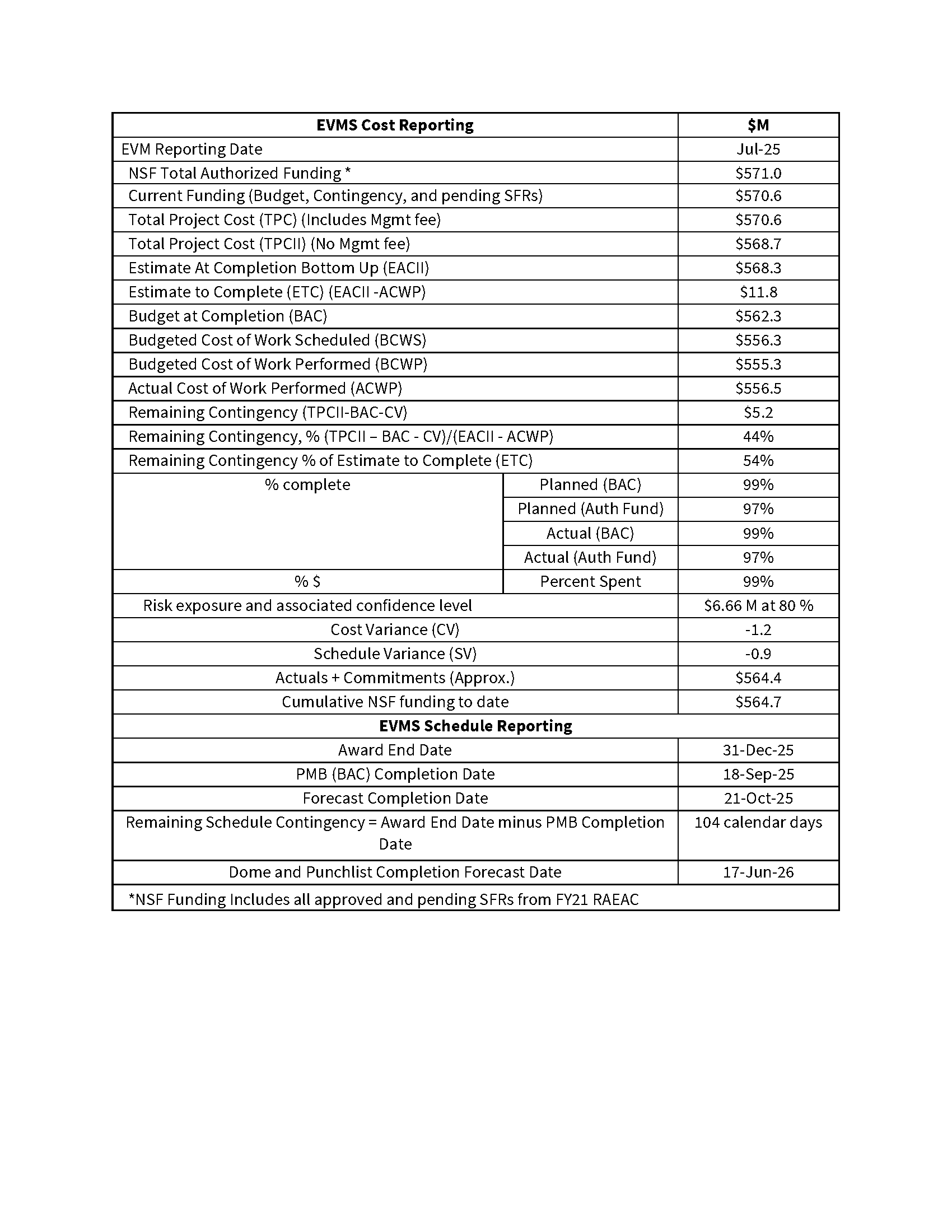

Top level Earned Value Management (EVM) Data Table
